Project location:Douliu City, Yunlin County
Contract price: 760,000,000 TWD
Contract period:853 days
Start date:2018/09/16
Completion date:2021/01/19
Employer: Water Resources Agency, MOEA
Design:Liming Engineering Consultants
Supervision:Central Region Water Resources Office, Water Resources Agency, Ministry of Economic Affairs
Construction :Earth Power Construction Co., Ltd. and Tachang Tsuo Machinery Industrial Co., Ltd.
Main project content:
Yunlin County is located on the south bank of
the downstream of the Zhuoshui River. Due to the river water quality and the
abundance of the flow, the daily water consumption of the Yunlin County
residents is mostly from the groundwater, causing the formation of most of the
Yunlin County to sink. To ensure the high quality of the tap water in the
Yunlin area from the ground water source and to slow down of the formation
decent rate, this project is carried by the Ministry of Economic Affairs' Water
Resources Department to provide a quality ground water source for tap water in
the Yunlin area.
The project is divided into a civil engineering
part and a hydraulic machinery part. It is used to handle the downstream gate
valve chamber, energy dissipator and water pipeline project of the water intake
tower. After completion, the water supply, anti-suppression and flood discharge
capacity of Hushan Reservoir Dam can be improved, to improve the raw water
quality to reduce the cost from water purification process.

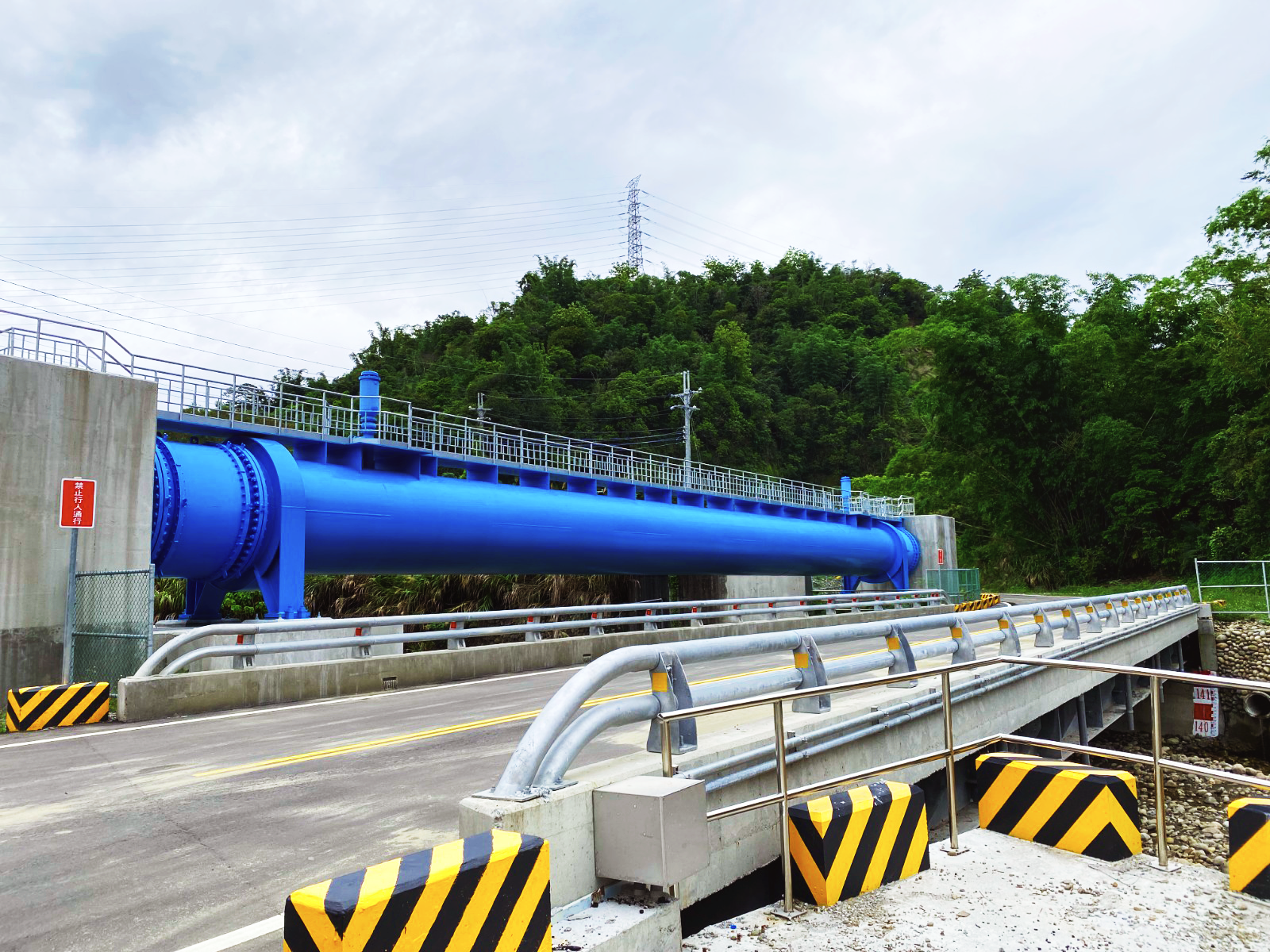

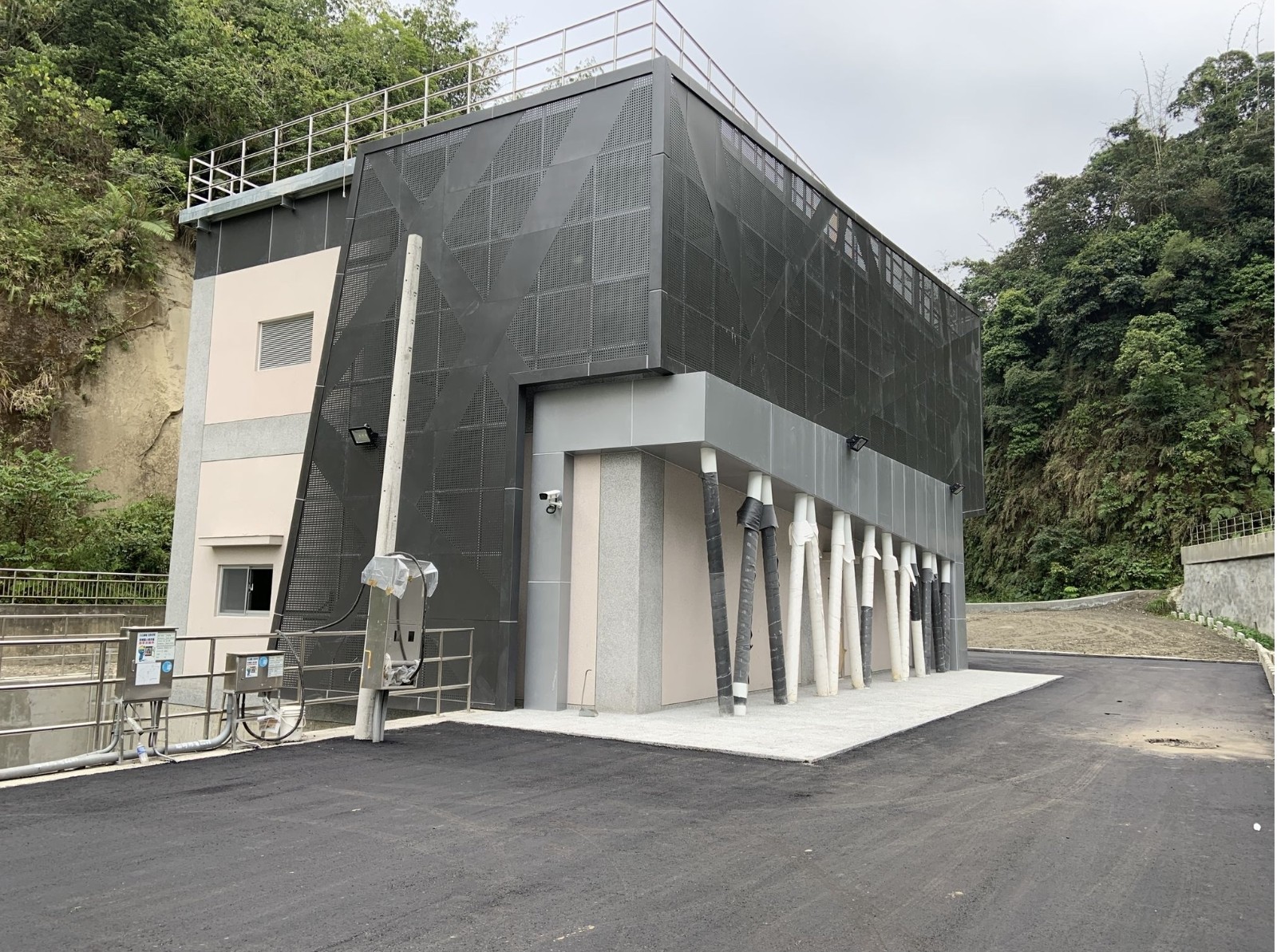

The main construction projects of this project are steel lining engineering, gate valve room engineering, energy dissipating engineering project, retaining soil pile engineering, downstream connecting pipeline engineering, bridge reconstruction/improvement engineering, and hydraulic machinery equipment manufacturing and installation. The steel pipe and hydraulic machinery are manufactured and manufactured in the manufacturing plant and transported to the site for installation. The bridge is rebuilt and the intensive steel I-beam bridge is reconstructed.
The
water conveyance road project includes the steel lining of the existing
construction water guiding tunnel (∮2.5m) and the length of 344.67m and the
water outlet of the tunnel exit and gate valve chamber (∮2.5m) is 39.85m long.
The starting point of the downstream connecting pipeline starts from the
butterfly valve end of the gate valve chamber. After the water pipe bridge
passes through the Beishangkeng River, it is buried under the right road of
Beishangkeng River. When the mileage is 0K+803.041, the inverted siphon worker
crosses the Beishangkeng River and is buried in the Beishangkeng River. Below
the left side of the road, until the end point is connected to the water pipe,
the total length is 1,210.701M, including the flowmeter well at 0K+029.959, the
pressure relief valve well at 0K+047.059, the relief well and the ball valve at
the end 1K+154.416 In each place, the gate valve of this project does not have
the function of energy dissipation. If the emergency drainage of the steel pipe
is used, it may cause the influence to the downstream river channel. Therefore,
one energy dissipator (length 43.9M wide and 10M) is installed at downstream of
the gate valve chamber.
This project was awarded the Golden Safety Award of High Distinction in the 14th, which is 2020. ▼
